Pepas MRE drilling near completion

Summary by AI BETAClose X

Orosur Mining Inc. has provided an update on its exploration activities, with the Pepas resource modelling and NI43-101 report process underway, highlighted by a significant drill intercept of 83.7m at 4.29g/t Au from surface in hole PEP067. Additionally, initial drilling at the El Pantano project in Argentina has confirmed a low sulphidation epithermal mineral system, with assays pending, and the company is progressing towards a Mineral Resource Estimate for Pepas, expected in January 2026.

Disclaimer*

Orosur Mining Inc
12 December 2025








Pepas MRE drilling near completion

Drilling at El Pantano in Argentina hits mineral system





·    Assays for five holes from the Pepas resource drilling program, including:

o PEP067 - 83.7m @ 4.29g/t Au from surface

·    Resource modelling and NI43-101 report process under way

·    First holes from El Pantano drilling program confirm a low sulphidation epithermal mineral system - awaiting assays.



London, December 12th, 2025. Orosur Mining Inc. ("Orosur" or the "Company") (TSXV/AIM:OMI), is pleased to announce an update on the progress of exploration activities at the Company's exploration projects at Anzá in Colombia ("Anzá) and El Pantano in Argentina ("El Pantano").



Anzá - Colombia



The Anzá Project in Colombia comprises a number of granted exploration titles and applications totalling roughly 330km2, within the Mid-Cauca gold belt, west of the city of Medellin.



These titles and applications are owned by two Colombian companies, Minera Anzá, and Minera Monte Aguila, both of which are wholly owned subsidiaries of the Company. The latter of these was acquired by Orosur in November 2024 from the Company's previous JV partners, Newmont Mining and Agnico Eagle Mines.  Orosur thus owns 100% of the Anzá Project.



Since acquiring 100% control, the Company has focussed its attention on three prospects:

·    Pepas - a shallow, high-grade body of gold mineralisation that the Company is endeavouring to move to an initial Mineral Resource Estimate ('MRE') in the near term.

·    APTA - a high-grade body of gold mineralisation that has to date seen 38,000m of drilling, but is not yet sufficiently understood geologically to allow a MRE to be calculated.  The Company plans to undertake additional drilling at APTA in 2026, with the objective of advancing it toward an MRE.

·    El Cedro - a large gold porphyry system in the south of the Project area. The Company has completed a large soil sampling program and plans to undertake a maiden drill program here in early 2026.

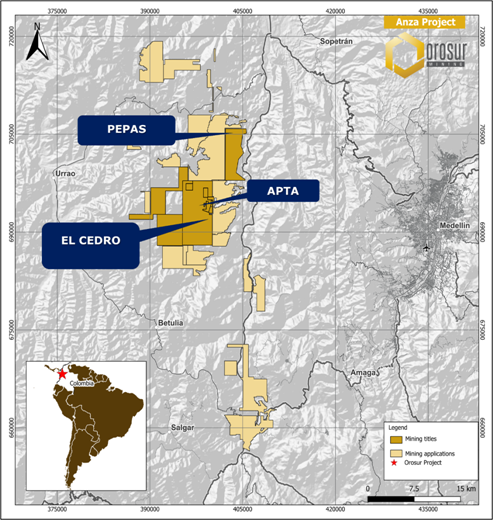

Figure 1. Anzá Project









As announced on 14th July 2025, the Company had taken the formal decision to commence infill drilling at its Pepas gold prospect at Anzá, with the objective of moving Pepas to a NI43-101 compliant Mineral Resource Estimate as quickly as possible.



The Company's external geological and resource consultants visited the Anza site at the start of November to carry out the necessary QAQC verification of drilling and sampling and to work with the Orosur geological team in the development of a new NI43-101 technical report for the Anza project, which will include a MRE for the Pepas Prospect.



One outcome of this visit was the recommendation by the consultants for an extension of the final stages of the MRE drill-out program, with several additional holes within and outside the Pepas deposit to define the boundaries of the current deposit envelope and obtain a better understanding of the size and controls of previously defined high-grade zones.



Holes drilled outside the deposit envelope have returned the lower grade halo mineralisation as expected and have provided valuable information as to the nature of the some of the controlling structures of Pepas. The one hole of this current batch drilled inside the deposit envelope (PEP-067) returned a result of 83.7m @ 4.29g/t Au from surface.





Hole Number

From (m)

To (m)

Interval (m)

Au (g/t)

PEP067

0

83.7

83.7

4.29

including

21.6

39.05

17.45

7.12

Including

61.7

72.5

10.8

8.06

PEP068

0

8

8

0.67


17.4

22

4.6

0.37


47.55

51

3.45

0.34

PEP069

0

2.25

2.25

0.96

PEP070

0

2

2

1.34


37.7

40.45

2.75

1.11


84.1

149.4

65.3

0.68

PEP071

0

3.2

3.2

0.42



71.35

78

6.65

0.45

Table 1. Latest drill Intercepts, Pepas Prospect

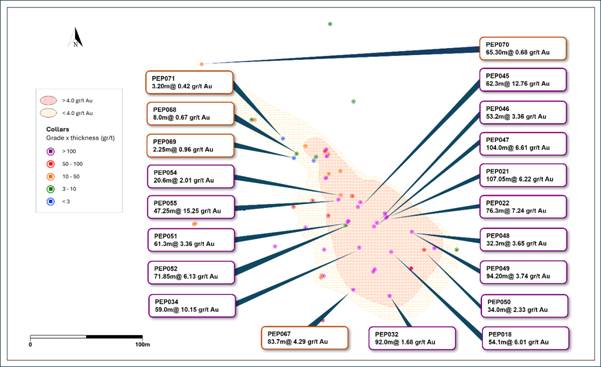

A screenshot of a computer AI-generated content may be incorrect.

Figure 2.  Plan of holes

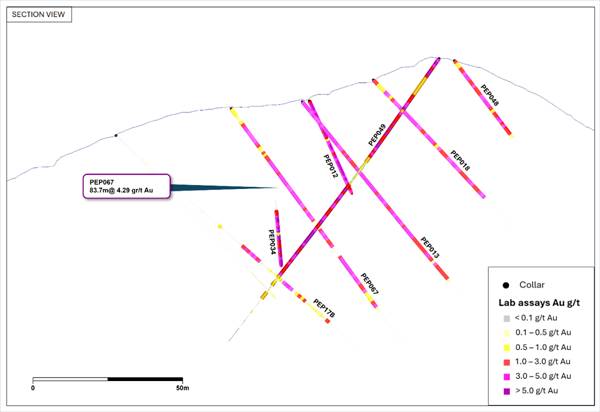

Figure 3. Section, PEP067





It is expected that the Pepas drill-out program will continue for the next few days and the resulting MRE and technical report can then be completed during January 2026.



Metallurgy

As part of the MRE process, a large diameter PQ drill hole was completed specifically to provide sufficient material for a comprehensive metallurgical testing program. These samples have been sent to the metallurgical testing facility of ALS Global in British Columbia, where the work is now well advanced. It is hoped this program may be completed by the end of the year and thus feed into the Technical Report and MRE.



Wider Exploration - Anza

The Company had previously announced that it had planned to undertake a detailed airborne magnetic survey over the EL Cedro and APTA prospects in December, as a tool to provide additional guidance for drilling in early 2026. The Company is engaging with contractors to commission the survey.



Mapping, sampling and trenching is also underway in the environs of the Pepas deposit, as part of an ongoing program to explore for extensions and/or repetitions of Pepas.  Once the current resource drilling program is completed in coming weeks, it is likely the rig will be shifted to targets being developed around Pepas.









El Pantano - Argentina



The El Pantano Project is an early-stage gold/silver exploration project in Santa Cruz province, southern Argentina.



The Project comprises approximately 550km2 of contiguous granted licences in the prolific Deseado Massif of Santa Cruz Province, roughly 45km from Anglo Gold's Cerro Vanguardia mining camp and 90km SE of Newmont Mining's giant Cerro Negro mine.



El Pantano is subject to an Exploration & Joint Venture ("JV") agreement ("Agreement") with private Argentinean company Deseado Dorado S.A.S and its shareholders ("Deseado"), the details of which were announced on February 15th 2022.



The Company currently owns 51% of El Pantano, having met its obligation to spend US$1m in exploration expenditure by February 2025. The Company is now in Phase 2 of the joint venture, whereby it may earn an additional 49% equity in the project (taking the Company to 100% ownership) by investing US$2m in the two years to February 2027.   Upon such an event, the original vendors would retain a 2% NSR royalty, 1% of which the Company could purchase for US$1m at its discretion.



Following several years of surface field work, the Company commenced the first phase of drilling ever undertaken within the project area in early November 2025.  Between 3,000-4,000m is planned across the breadth of the project area as a reconnaissance program designed to address a number of geological questions:

·    Test sources of geochemical anomalism

·    Assess a variety of Induced Polarisation responses

·    Intersect, if possible, mineralised structures indicative of the low sulphidation epithermal model being postulated at El Pantano

·    Gain understanding of the vertical variations in the system, especially in relation to the potential for fluid boiling.



In a general sense, the broad objective of the program is to determine if a mineral system is present at El Pantano, and if so, develop exploration plans for further work.

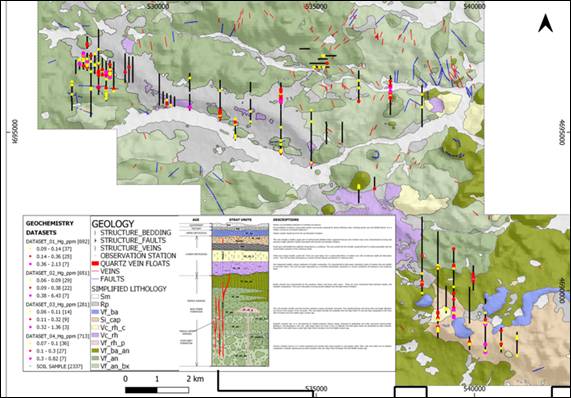

Figure 4.  El Pantano geology and geochemistry



Samples from the El Pantano project are sent to the preparation facility and fire assay laboratory of Alex Stewart Laboratories in Perito Moreno to be assayed for gold.  Pulps are then sent to the larger Alex Stewart facility in Mendoza for multi-element analysis.



To date, seven holes have been completed with samples from the first five submitted to the laboratory in Perito Moreno for fire assay gold analysis, to be followed by multi- element analysis, including silver, from the Mendoza facility.



Visually, several of the holes have intersected extremely encouraging structures showing textures and mineralogy consistent with what is seen in other low sulphidation epithermal systems in the region.  In particular, the presence of colloform banding in several intersected narrow veins is a key indicator often seen in the core of low sulphidation epithermal systems.



Preliminary interpretation would suggest that vein textures are indicative of lower temperatures, albeit with some examples of higher temperature overprinting.  This would suggest that current drilling is still higher in the system, above the boiling zone.

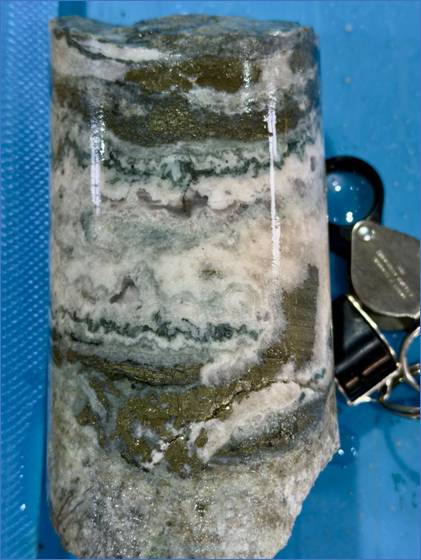

A close up of a bottle AI-generated content may be incorrect.

Fig 5. Colloform banding, El Pantano







The Company is confident that it has achieved its general objective of proving the existence of a substantial mineral system. This is an extremely positive and unusual result for the first drilling program on a grass roots project. The challenge, however, is identifying where, within the mineral system, economic widths and grades may have been deposited.



Drilling is progressing faster than anticipated and thus it is planned that this program will be completed toward the end of January 2026.  Once complete, all new and historical data will be compiled as the key component to a targeting program that will develop the next phase of work.













Orosur CEO Brad George commented:

"Pepas is now in the final mile of its MRE process and the pieces are coming together for a January report.  In the meantime, we are lining up targets for when the rig is freed up later in December.  Drilling at El Pantano, as with any undrilled project, was high risk, but we have hit what we hoped to hit - a previously unknown mineral system.  Now we need to focus in, and given the scale of the system, that is a challenge….but a good challenge".









For further information, visit www.orosur.ca, follow on X @orosurm or please contact:



Orosur Mining Inc

Louis Castro, Chairman,

Brad George, CEO

info@orosur.ca

Tel: +1 (778) 373-0100



SP Angel Corporate Finance LLP - Nomad & Joint Broker

Jeff Keating / Jen Clarke / Devik Mehta

Tel: +44 (0) 20 3470 0470



Turner Pope Investments (TPI) Ltd - Joint Broker

Andy Thacker/Guy McDougall
Tel: +44 (0)20 3657 0050



Flagstaff Communications and Investor Communications

Tim Thompson
Mark Edwards
Fergus Mellon

orosur@flagstaffcomms.com

Tel: +44 (0)207 129 1474



The information contained within this announcement is deemed by the Company to constitute inside information as stipulated under the Market Abuse Regulations (EU) No. 596/2014 ('MAR') which has been incorporated into UK law by the European Union (Withdrawal) Act 2018. Upon the publication of this announcement via Regulatory Information Service ('RIS'), this inside information is now considered to be in the public domain.



Neither TSX Venture Exchange nor its Regulation Services Provider (as that term is defined in policies of the TSX Venture Exchange) accepts responsibility for the adequacy or accuracy of this release.







Drill Hole Details - Pepas prospect 2022/2024 Programme*

Hole ID

Easting (m)

Northing (m)

Elevation asl (m)

Dip (°)

Azimuth (°)

PEP-001

403384

705000

1001

-50

150

PEP-002

403384

705000

1001

-60

290

PEP-003

403240

705142

1001

-49.60

95.2

PEP-004

403508

705671

838

-59.8

99.8

PEP-005

403373

704990

1008

-49.8

94.6

PEP-007

403374

704990

1008

-69.9

170

PEP-008

403232

704803

971

-50

60

PEP-009

403032

705057

1055

-50

80

PEP-010

403375

705106

982

-50.31

190.4

PEP-011

403573

704939

1001

-50.3

255

PEP-012

403415

704890

997

-56

352

PEP-013

403413

704887

997

-50

43

PEP-014

403400

704910

1007

-50

43

PEP-015

403375

704938

1017

-50

43

PEP-016

403326

704912

999

-50

43

PEP-017

403365

704848

976

-40

47

PEP-018

403345

704851

977

-45

43

PEP-019

403446

704890

991

-45

43

PEP-020

403446

704890

991

-75

43

PEP-021

403424

704935

1012

-62

223

PEP-022

403424

704935

1012

-42

223

PEP-023

403245

704927

969

-50

43

PEP-024

403245

704927

969

-78

43

PEP-025

403369

704888

1001

-45

43

PEP-026

403339

704955

1008

-63

50

PEP-027

403468

704909

1003

-46

228

PEP-028

403398

704957

1012

-58

223

PEP-029

403311

705018

1011

-50

50

PEP-030

403311

705018

1011

-50

000

PEP-031B

403486

704901

998

-52

220

PEP-032

403431

704861

982

-60

15

PEP-033

403431

704861

982

-65

100

PEP-034

403431

704861

982

-45

315

PEP-035

403369

704882

996

-45

223

PEP-036

403311

705152

989

-45

30

PEP-037

403354

705227

958

-50

210

PEP-038

403332

705219

967

-45

128

PEP-039

403411

704798

957

-45

73

PEP-040

403369

704882

995

-80

212

PEP-041

403373

704936

1008

-50

3

PEP-042

403396

705038

716

-50

82

PEP-043

403298

704942

981

-50

43

PEP-044

403402

704948

1011

-62

33

PEP-045

403406

704949

1011

-60

223

PEP-046

403420

704933

1007

-53

43

PEP-047

403414

704927

1008

-74

223

PEP-048

403448

704922

1005

-54

043

PEP-049

403447

704920

1005

-55

223

PEP-050

403459

704905

1003

-45

43

PEP-051

403391

704928

1011

-61

43

PEP-052

403391

704928

1011

-87

43

PEP-053

403391

704929

1012

-60

223

PEP-054

403380

704954

1011

-52

43

PEP-055

403380

704954

1011

-86

223

PEP-056

403371

704970

1012

-61

43

PEP-057

403371

704970

1012

-71

223

PEP-058

403371

704970

1012

-85

223

PEP-059

403384

704976

1007

-59

43

PEP-060

403372

704908

1005

-55

43

PEP-061

403361

704988

1010

-80

223

PEP-062

403361

704988

1010

-61

43

PEP-063

403345

705005

1009

-50

80

PEP-064

403356

704923

1005

-51

43

PEP-065

403359

704949

1008

-59

43

PEP-065B

403359

704949

1008

-50

43

PEP-066

403423

704938

1009

-64

223

PEP-067

403400

704870

990

-53

43

PEP-068

403342

704989

1010

-56

43

PEP-069

403342

704987

1010

-80

218

PEP-070

403260

705071

1013

-50

30

PEP-071

403333

705005

1009

-51

90





Drill Hole Details, El Pantano Project 2025 onward

Hole ID

Easting (m)

Northing (m)

Elevation asl (m)

Dip (°)

Azimuth (°)

ELP-001

527906

4697061

285

-50

190

ELP-002

527970

4697238

266

-50

190

ELP-003

528007

4697338

266

-50

190

ELP-004

528044

4697438

266

-50

190

ELP-005

527831

4697342

266

-55

010

ELP-006

527831

4697342

266

-50

010

ELP-007

529162

4696630

320

-50

010

ELP-008

530497

4695922

285

-55

020



Coordinates WGS84, UTM Zone 18





About Orosur Mining Inc.

Orosur Mining Inc. (TSXV: OMI; AIM: OMI) is a minerals explorer and developer currently operating in Colombia and Argentina.



Qualified Persons Statement

The information in this news release was compiled, reviewed, verified and approved by Mr. Brad George, BSc Hons (Geology and Geophysics), MBA, Member of the Australian Institute of Geoscientists (MAIG), CEO of Orosur Mining Inc. and a qualified person as defined by National Instrument 43-101.



Orosur Mining Inc. staff follow standard operating and quality assurance procedures to ensure that sampling techniques and sample results meet international reporting standards.



Drill core is split in half over widths that vary between 0.3m and 2m, depending upon the geological domain. One half is kept on site in the Minera Anzá core storage facility in the case of the Anza Project, or on site in temporary racks in the case of the El Pantano Project, with the other sent for assay.



Industry standard QAQC protocols are put in place with approximately 10% of total submitted samples being blanks, repeats or Certified Reference Materials (CRMs).



Samples for holes PEP-001 to PEP-011 were sent to the Medellin preparation facility of ALS Colombia Ltd, and then to the ISO 9001 certified ALS Chemex laboratory in Lima, Peru.



Samples from PEP-012 onwards are sent to Medellin laboratory of Actlabs for preparation and fire assay, with some sample then sent to the Canadian Actlabs facility for multi element assay



Samples from the EL Pantano project are sent to the preparation facility and fire assay laboratory of Alex Stewart Laboratories in Perito Moreno to be assayed for gold.  Pulps are then sent to the larger Alex Stewart facility in Mendoza for multi-element analysis.



30 gram nominal weight samples are then subject to fire assay and AAS analysis for gold with gravimetric re-finish for overlimit assays of >5 g/t.  ICP-MS Ultra-Trace level multi-element four-acid digest analyses may also undertaken for such elements as silver, copper, lead and zinc, etc.
